| Metric | Result | Context |
|---|---|---|
| 4 | Vertical Kiln Shafts Fabricated | Each shaft fabricated and pre-assembled by AAA Fabrication before delivery to Clifton, Texas |
| 250,000 lbs. | Weight Per Kiln Shaft | Four shafts at approximately 250,000 lbs. each — 1,000,000 lbs. of kiln structure total |
| 1.4M lbs. | Total Steel Fabricated | 1,000,000 lbs. of kiln shafts plus 400,000 lbs. of supporting structural steel |
| 1+ Year | Field Installation Time Removed | Shop pre-assembly cut more than a year from the anticipated field installation timeline |
| 11 Months | Fabrication Timeline | February 2025 through December 2025, from engineering and planning through final delivery |
| 0 | Safety Incidents | Project executed incident-free |

Project Overview
AAA Fabrication was contracted by Lhoist North America to fabricate and pre-assemble four massive vertical kiln shafts for its Clifton, Texas facility. Each shaft weighed approximately 250,000 pounds, with the four shafts totaling 1 million pounds and an additional 400,000 pounds of supporting structure bringing the total project weight to approximately 1.4 million pounds.
By completing major assemblies in a controlled fabrication environment before delivery, AAA Fabrication significantly reduced the amount of work required in the field, cutting more than one year from the anticipated installation timeline. The project was completed incident-free and represented an exceptional achievement in large-scale industrial fabrication.
Equipment Specifications
Four vertical kiln shafts and their supporting structural steel were fabricated and pre-assembled in the shop prior to delivery to Clifton, Texas.
| Component | Qty | Fabrication Scope | Weight |
| Vertical Kiln Shaft | 4 | Fabricated and pre-assembled in shop | 250,000 lbs. per shaft |
| Supporting Structural Steel | — | Structural support framing | 400,000 lbs. total |
| Total — 4 Kiln Shafts | 4 | Delivered as large pre-assembled sections | 1.4 million lbs. total fabricated weight |
Scope of Work
AAA Fabrication executed the vertical kiln project across three phases of work, from engineering through pre-assembly and delivery:
Engineering & Planning — AAA Fabrication
- Project engineering led by Fernando Vasquez
- Engineering planning and fabrication sequencing led by Gerardo
- Translation of demanding technical and logistical requirements into an executable shop process
- Coordination with Lhoist North America across the February–December 2025 build
Fabrication — AAA Fabrication
- Fabrication of 4 vertical kiln shafts at approximately 250,000 lbs. each
- Approximately 400,000 lbs. of supporting structural steel fabricated
- Approximately 1.4 million lbs. of steel managed across the full project
- Shop operations directed by shop foreman Carlos Ramirez
Pre-Assembly & Delivery — AAA Fabrication
- Major kiln assemblies completed in the fabrication shop prior to shipment
- Large pre-assembled sections transported to the Clifton, Texas site
- Field assembly requirements significantly reduced through controlled shop fabrication
- More than one year cut from the anticipated field installation timeline

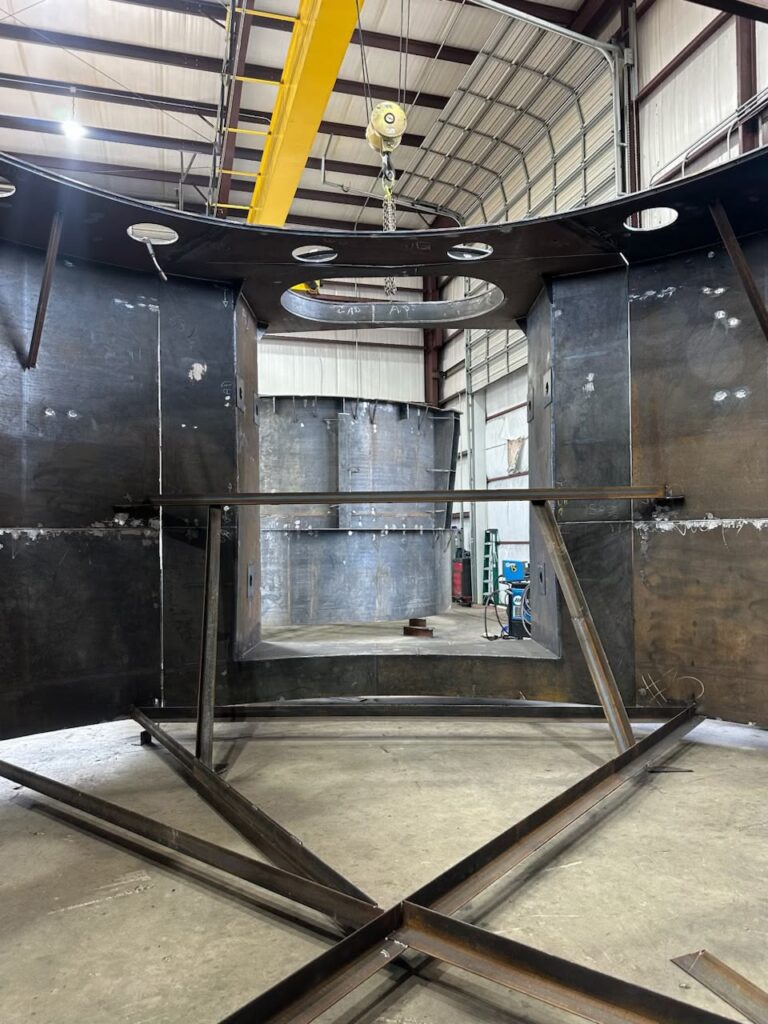

Large-Assembly Fabrication Capability
AAA Fabrication’s shop capacity is not limited to conventional structural steel packages. On this project the team fabricated and pre-assembled four vertical kiln shafts at approximately 250,000 pounds each, plus roughly 400,000 pounds of supporting structure — approximately 1.4 million pounds of steel handled in a controlled shop environment and delivered to site as large, completed assemblies rather than loose components.
For process producers, this matters. Field time is the most expensive and least predictable part of a major kiln build, constrained by weather, site access, crane availability, and crews working at height. Every assembly that leaves the shop complete is an assembly nobody has to build in the field. On this project, that moved more than a year out of the field installation schedule. Shop-built. Site-ready. Field time removed.

What Made This Exceptional
1.4 Million Pounds of Fabrication
The sheer scale of the project required AAA Fabrication to manage approximately 1.4 million pounds of steel across the four kiln shafts and their supporting structures.
Each individual shaft weighed approximately 250,000 pounds, making transportation, fabrication, assembly, and project coordination critical to successful execution.
A North American First
AAA Fabrication built the only two vertical kiln projects of their kind ever built in North America.
The project required the fabrication team to execute an exceptionally complex and large-scale build while coordinating engineering, planning, shop operations, and delivery requirements.
Pre-Assembly That Changed the Installation Timeline
One of the project’s biggest advantages was AAA Fabrication’s ability to complete significant assembly work before the structures reached the job site.
By delivering large assemblies to the site rather than requiring extensive fabrication and assembly in the field, the project team was able to cut more than a year from the field installation timeline.
This approach demonstrates the value of large-scale shop fabrication and pre-assembly when field time is a major project constraint.
Engineering & Planning
The project’s successful execution depended on close coordination between engineering, planning, and fabrication.
Fernando Vasquez handled the project’s engineering, while Gerardo oversaw planning and coordination.
Their work helped translate the project’s demanding technical and logistical requirements into a fabrication and assembly process capable of handling the enormous scale of the structures.
Results & Impact
| Metric | Outcome |
| Vertical Kiln Shafts | 4 |
| Weight Per Shaft | 250,000 lbs. |
| Total Shaft Weight | 1,000,000 lbs. |
| Supporting Structure | 400,000 lbs. |
| Total Project Weight | 1.4 million lbs. |
| Field Installation Time | More than 1 year reduced |
| Pre-Assembly | Large assemblies completed prior to delivery |
| Safety | Incident-free |
| Project Timeline | February–December 2025 |
